Document Collection Overview
Quick Navigation
HCR Wright Hassall Letters (URGENT - COURT PROCEEDINGS THREATENED)
Letters from opposing solicitor representing Mr Al Sarpong. Latest letter (9 Jan 2026) threatens court proceedings within 14 days.
-
View
3 October 2025 - WH to KG Project
Initial letter from Wright Hassall demanding action on roof repairs and insurance
-
View
14 November 2025 - WH to KG Project and Ross Paterson
Follow-up letter with additional demands and deadlines
-
View
9 January 2026 - HCR Wright Hassall to Benchmark (LATEST)
COURT PROCEEDINGS THREATENED - 14-day deadline to respond or proceedings will commence
-
View
Stan Harris Letter (Referenced by WH)
Original Stan Harris letter that Wright Hassall refers to in their correspondence
-
View
Leaseholder Notice for Insurance Cover
Notice regarding insurance documentation requirements
-
View
Photograph roof.docx
Roof photographs referenced in WH correspondence
CRITICAL EVIDENCE DISCOVERIES - Key Defence Points
Recently discovered evidence that significantly strengthens KG Project's defence against Wright Hassall's claims.
Evidence Discovery #1: The March 2021 "Notification" Myth
Wright Hassall Claim: KG Project "was notified of roof issues in March 2021" and failed to act - suggesting landlord neglect over 11 months before the 2022 repairs.
THE ACTUAL EVIDENCE (Emails 31 March - 1 April 2021):
Al's email (31 March 2021):
"My only immediate concern would be the roof - there was a leak during a heavy bout of rain back in October. It has not happened since then... Is the roof solely my responsibility or does it come under the coverage of the freehold?"
Katerina's response (1 April 2021):
"In regards of roof renovation issue I have to look into Lease Agreement and get back to you shortly."
WHY THIS DESTROYS WH's ARGUMENT:
- The leak Al mentioned was from October 2020 - 5 months before the email
- Al explicitly stated "It has not happened since then" - the leak had STOPPED
- Al was asking an informational question, not demanding urgent repairs
- Al himself said renovation works should wait until "next year" (2022)
- Katerina acknowledged and said she'd check the lease - reasonable for a non-emergency
- The March 2022 repairs were for a NEW, DIFFERENT leak - confirmed by Al's 29 Jan 2023 email: "nearly a year since the leak first occurred"
Evidence Discovery #2: The Two Different Leaks
The documentary evidence proves there were two separate leak incidents - not one ongoing problem:
| Date | Event | Outcome |
|---|---|---|
| October 2020 | Single leak during heavy rain | Resolved itself - "has not happened since" |
| 31 March 2021 | Al asks informational question about roof responsibility | Katerina says she'll check lease - no emergency |
| ~Feb 2022 | NEW leak - emergency roof works done | This is the disputed £3,500 |
| 29 Jan 2023 | Al says "nearly a year since leak first occurred" | Confirms 2022 leak was NEW - not from 2020 |
Strategic Significance: Wright Hassall cannot claim Katerina ignored a roof problem for 11+ months. The October 2020 leak stopped on its own. The March 2022 emergency was a completely separate incident.
Lease & Title Documents
Official Land Registry documents and lease agreements
-
View
Official Copy (Lease) 08.11.2013 - TGL388326
The original lease agreement dated 8 November 2013 - KEY DOCUMENT
-
View
Official Copy (Register) - SGL301847
Land Registry register for freehold title
-
View
Official Copy (Register) - TGL388326
Land Registry register for leasehold title
-
View
Official Copy (Title Plan) - SGL301847
Title plan showing property boundaries
-
View
Lease Analysis Brief
Summary analysis of key lease terms and obligations
Tribunal Preparation Materials
Legal analysis and evidence bundle documents prepared for potential tribunal proceedings
Legal Analysis
-
View
Legal Analysis for Tribunal
Comprehensive legal analysis of the dispute for tribunal
-
View
Legal Commentary (Comprehensive)
Detailed legal commentary on all issues
-
View
Legal Summary - Solution Roofing (Corrected)
Analysis of Solution Roofing contractor issues
-
View
Timeline of Conduct
Chronological timeline of conduct and events
-
View
Costs Analysis and Protection
Analysis of costs and protection strategies
-
View
Draft Letter - Costs Reservation
Draft letter regarding costs
-
View
Main Questions about Costs
Key questions regarding cost allocation
Tenant Breach Files
-
View
Breach 1: Ground Rent Arrears
Documentation of ground rent non-payment
-
View
Breach 2: Insurance Contribution
Documentation of insurance contribution issues
-
View
Breach 3: Retained Parts Works Contribution
Analysis of contribution obligations for retained parts
Evidence Bundle
-
View
Evidence of Trespass and Breach
Evidence regarding unauthorized roof works
-
View
Evidence of Payment Irregularities
Documentation of payment to JS Whitbread
-
View
Evidence of Trespass and Breach (Updated)
Updated evidence documentation
Contractor Legitimacy Evidence
-
View
Solution Roofing - Incorporation Docs
Companies House incorporation documents
-
View
Companies House - Strike Off Notice
Notice of intended strike off
-
View
Companies House - Dissolution Document
Final dissolution documentation
WH Letter Analysis
Roof Trespass & Significant Alteration Evidence
Photographic evidence proving Al Sarpong carried out SIGNIFICANT ROOF ALTERATIONS (not emergency repairs as claimed by Al and Wright Hassall) without freeholder consent - constituting trespass to Retained Parts.
- Not Emergency Repairs: Invoice shows planned work costing £3,500 including leadwork repointing, tile replacement, and rubberised coating installation
- Significant Alteration: Photos show systematic slate replacement across substantial roof area
- Trespass: Work done on shared Retained Parts without freeholder consent
- Pre-planned: Work completed Feb 16, 2022 but KG Project only notified March 2, 2022
Invoice & Documentation (Al-Katerina Communication, Sept 2022)
-
View

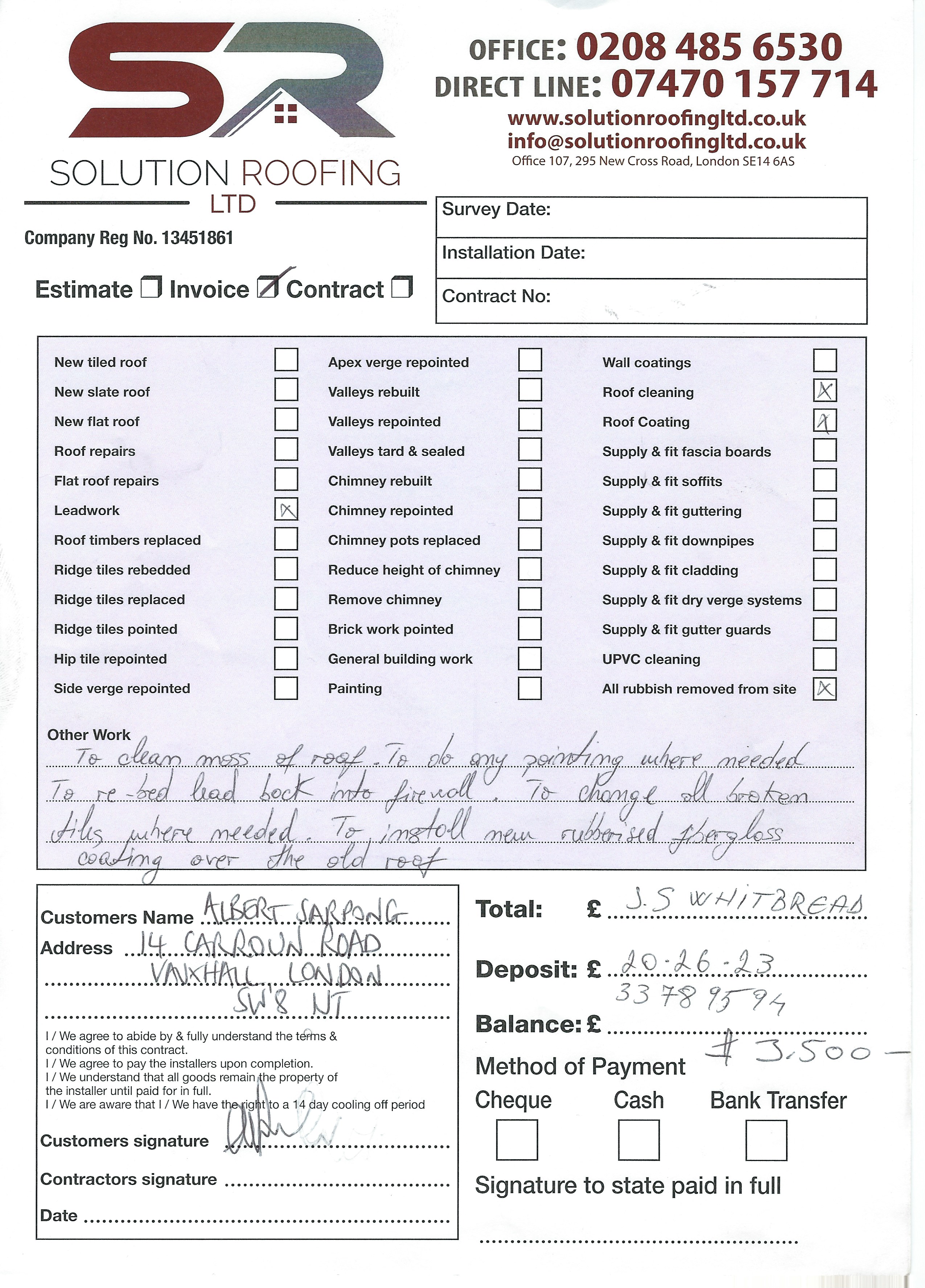

Solution Roofing Invoice/Contract
Shows work specification for £3,500: leadwork repointing, tile replacement, rubberised fibreglass coating - NOT simple emergency repair
-
View
Invoice Documentation Page 2
Additional invoice/contract documentation from Solution Roofing
-
View

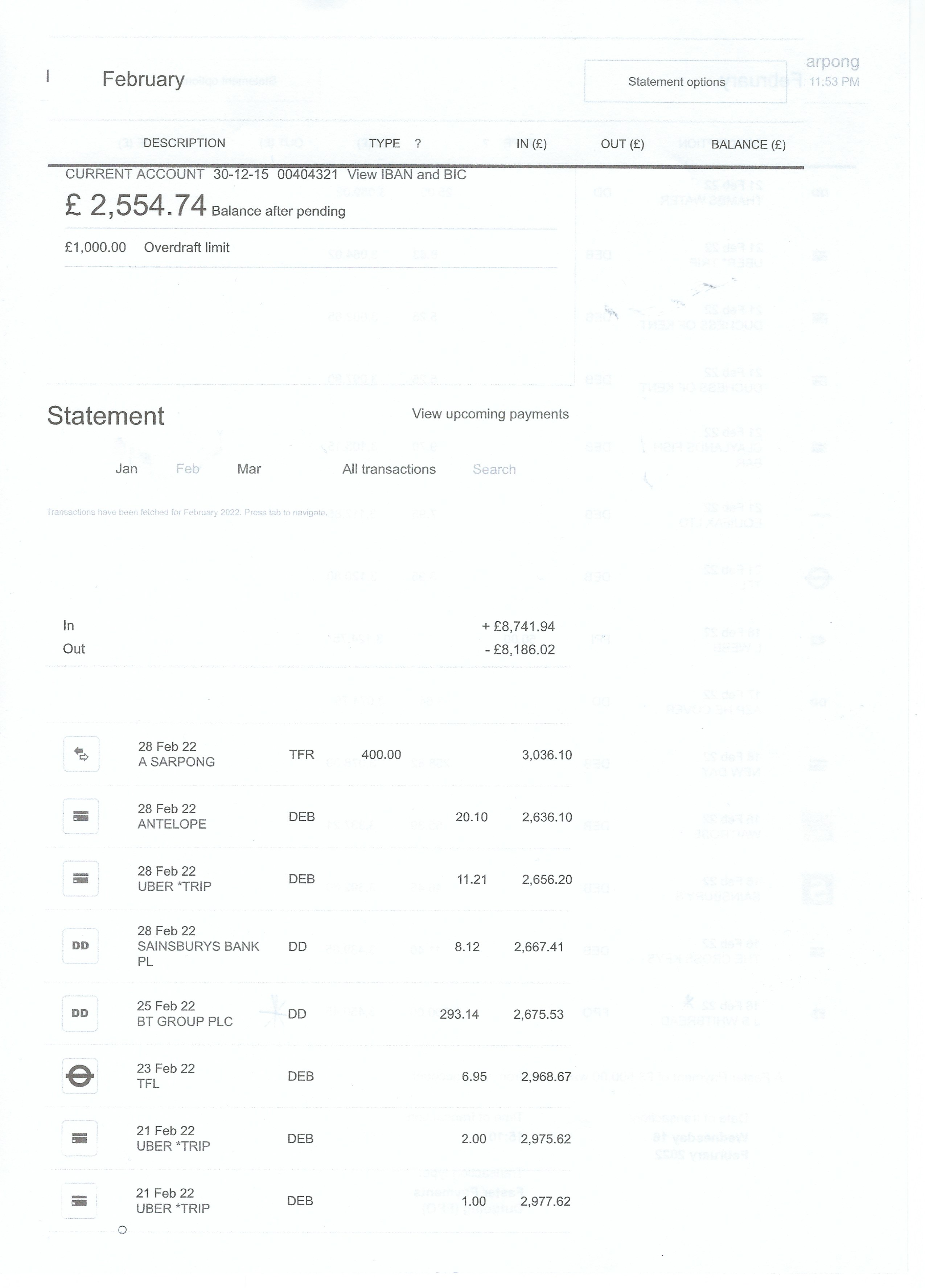

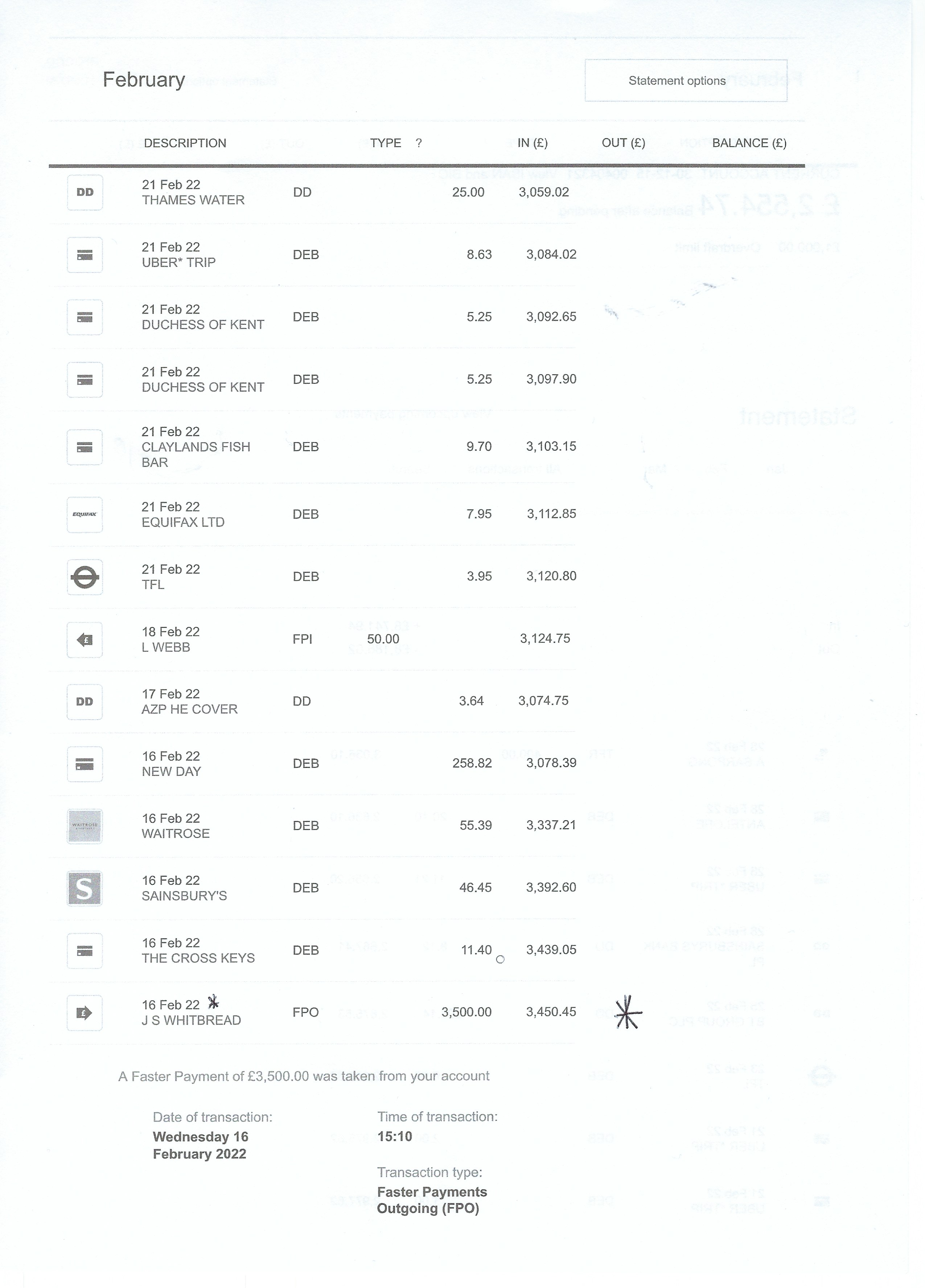

Bank Statement / Payment Proof
Evidence of £3,500 payment to J.S Whitbread (not to Solution Roofing Ltd directly)
-
View
10-Year Guarantee Certificate
Solution Roofing guarantee certificate - indicates substantial work, not emergency patching
-
View

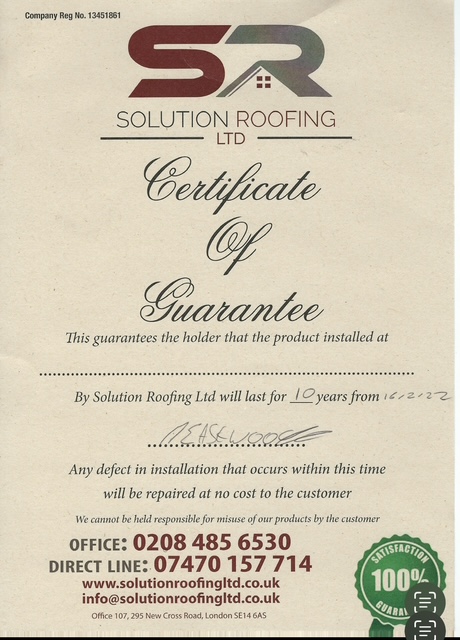

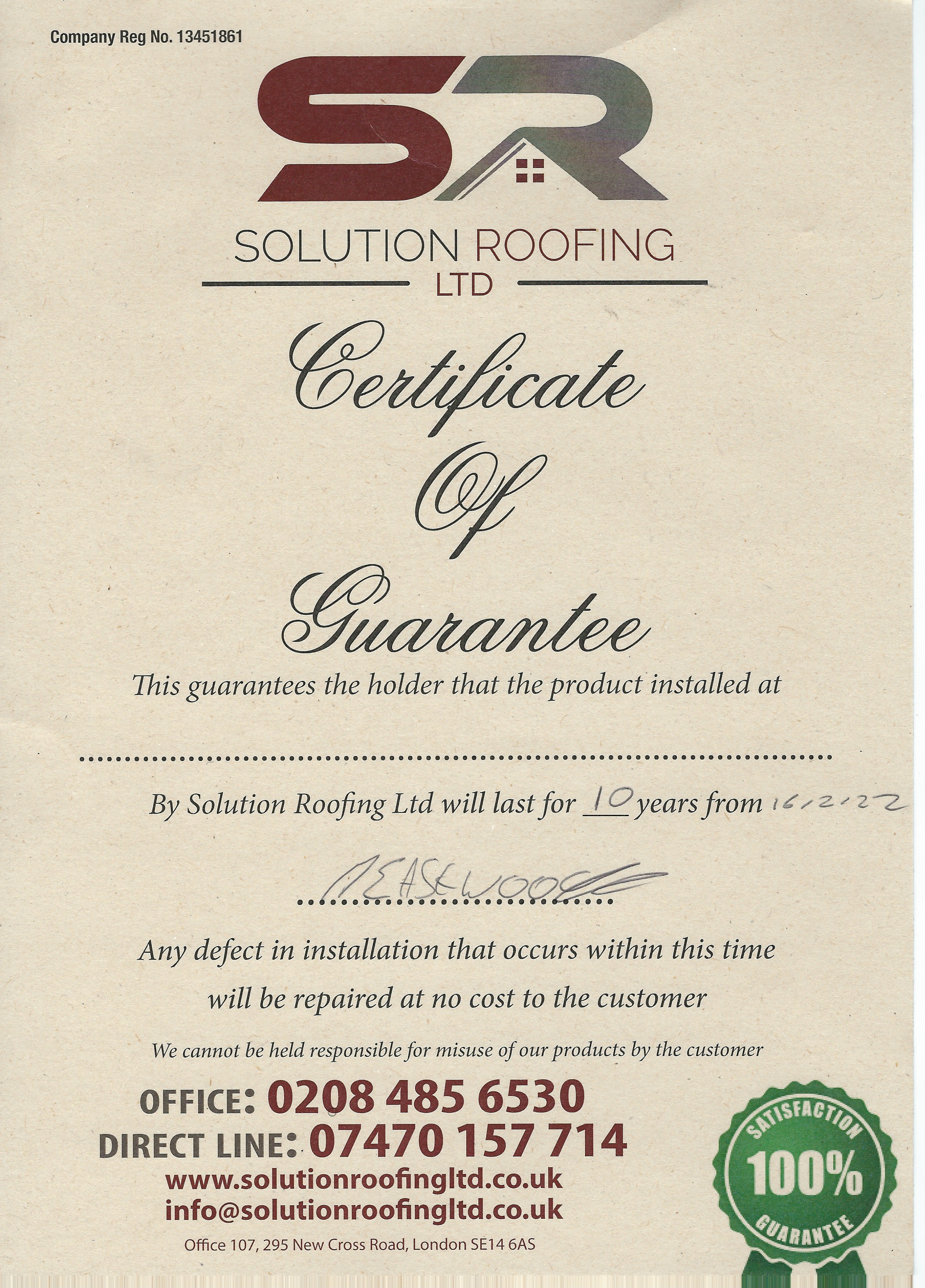

Solution Roofing Guarantee Certificate (Original)
10-year guarantee from Solution Roofing Ltd dated 16/02/22
Roof Work Photographs (Al-Stan Communication)
These photos were attached by Al Sarpong in correspondence with Stan Harris showing the extent of roof alterations. Note the clear contrast between old weathered slates and newly laid dark slates.
-
View

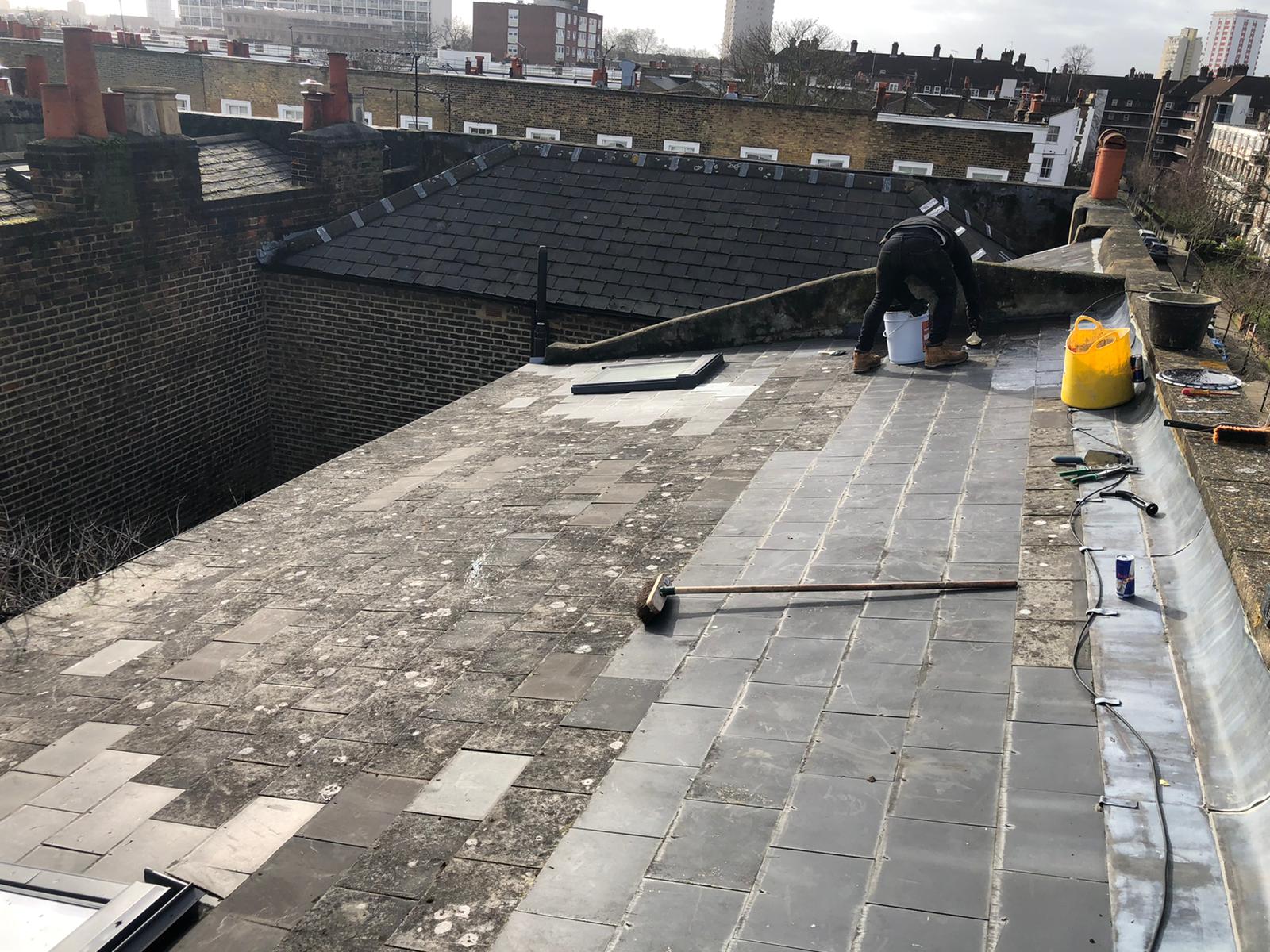

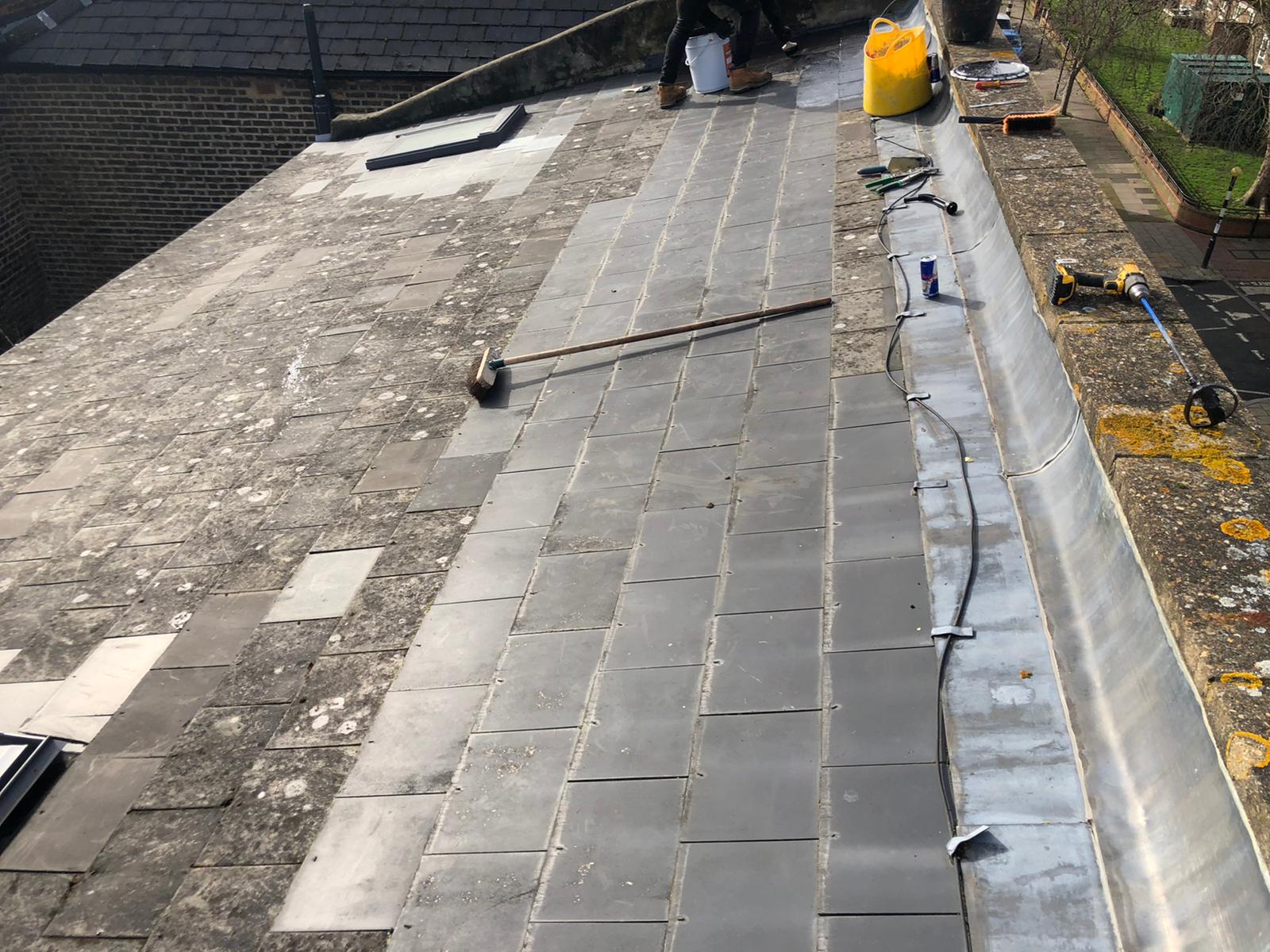

Roof Photo 1 - Workers on Site
Shows contractor actively working on roof, laying new slates - evidence of extensive work in progress
-
View

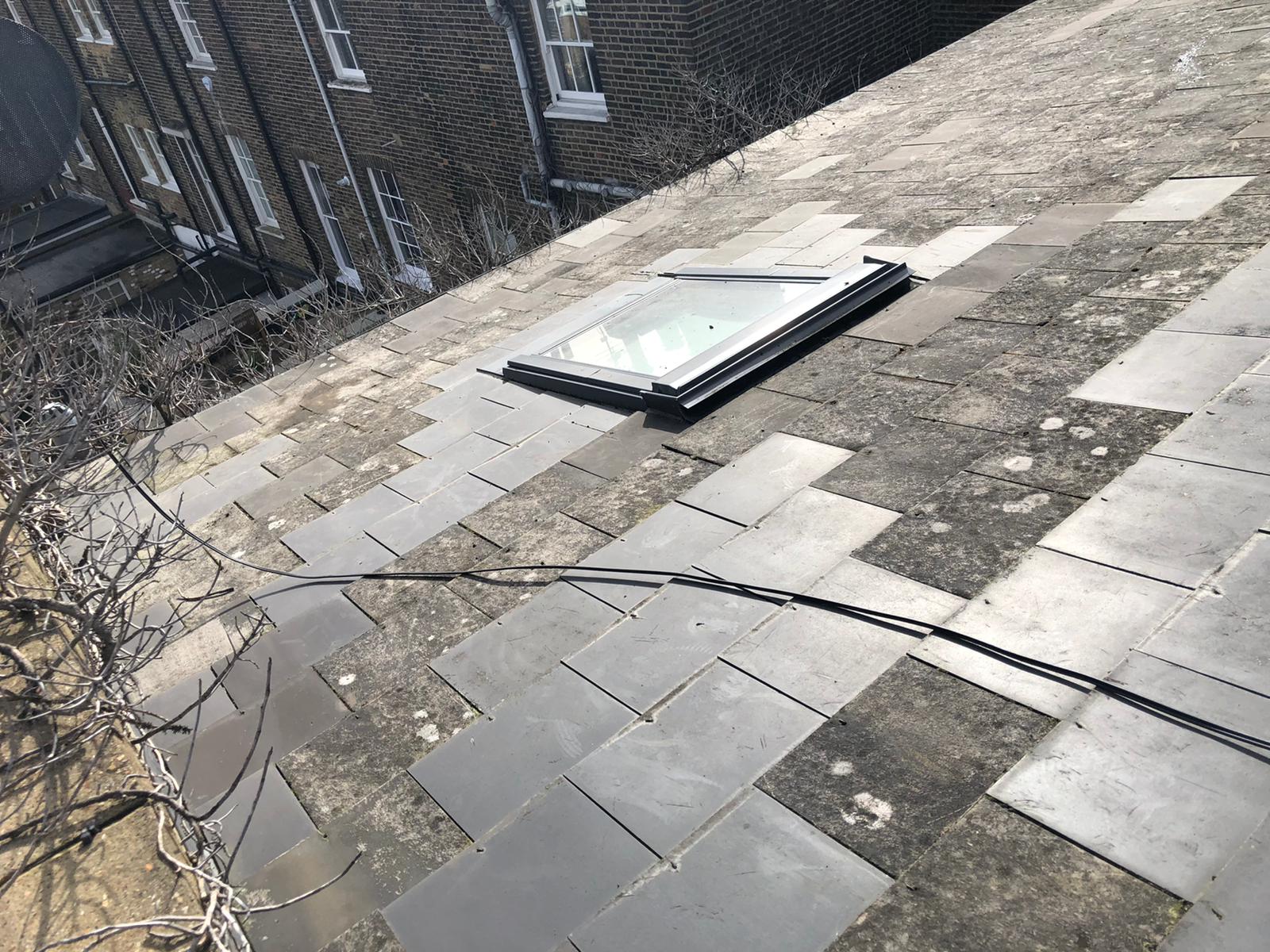

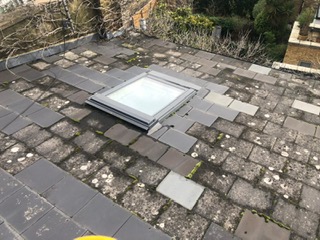

Roof Photo 2 - Skylight Area
Shows roof with skylight, contrast between old and new slates visible
-
View

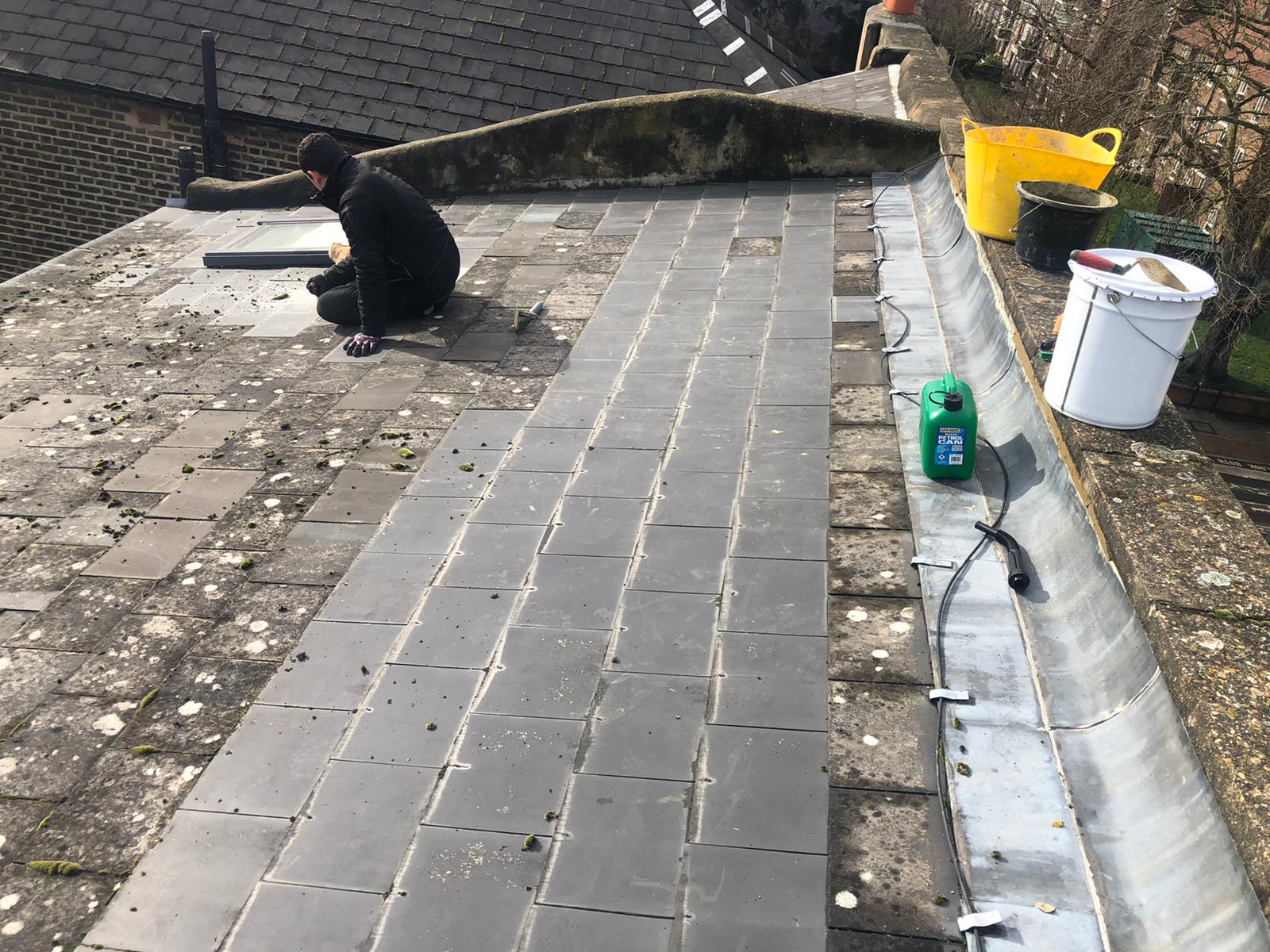

Roof Photo 3 - Slate Replacement
Clear view of systematic slate replacement - old weathered vs new dark slates
-
View
Roof Photo 4
Additional roof condition photograph
-
View
Roof Photo 5 - Extent of Work
Shows substantial portion of roof affected by works
-
View

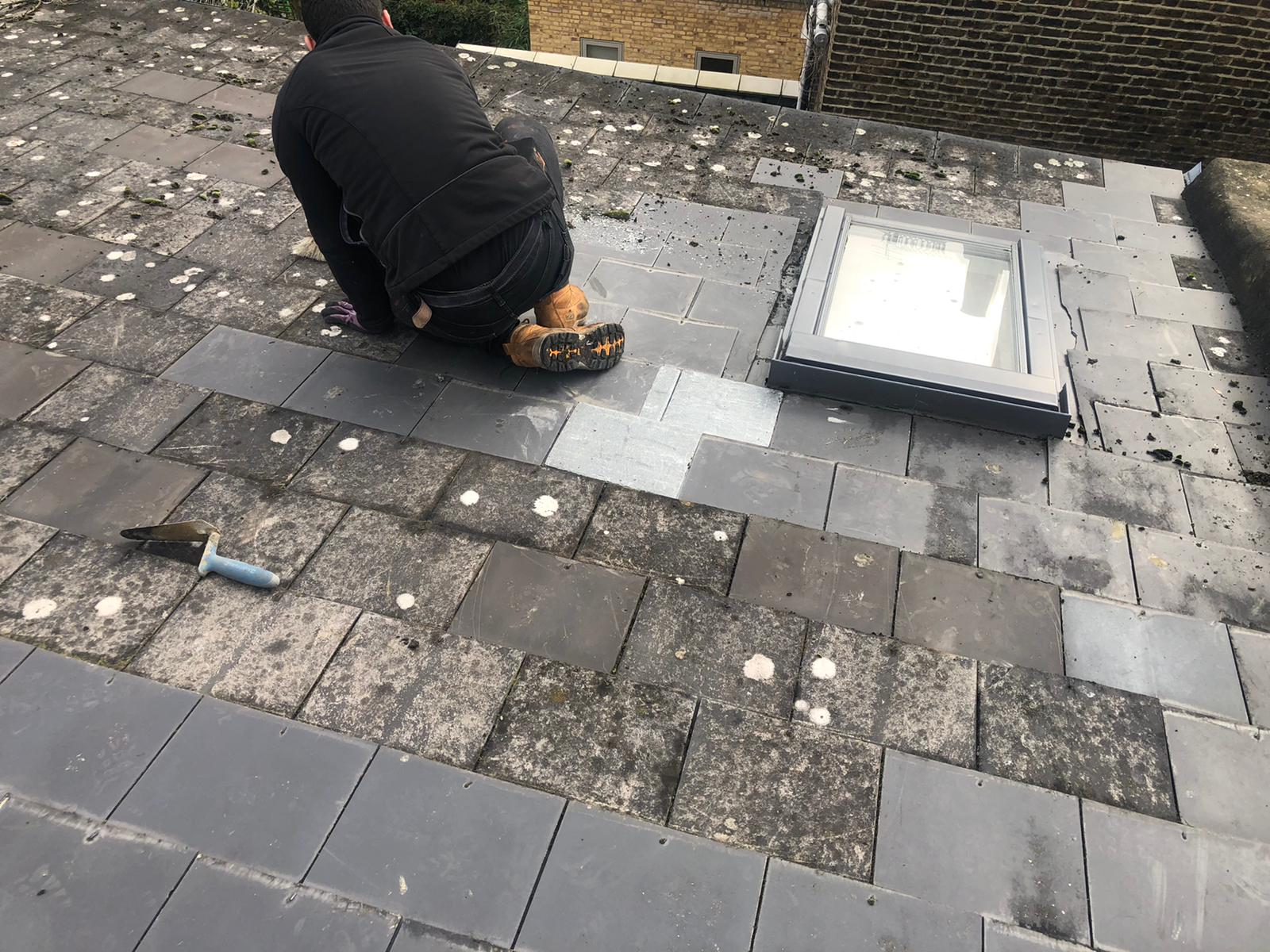

Roof Photo 6
Additional view of roof alterations
-
View

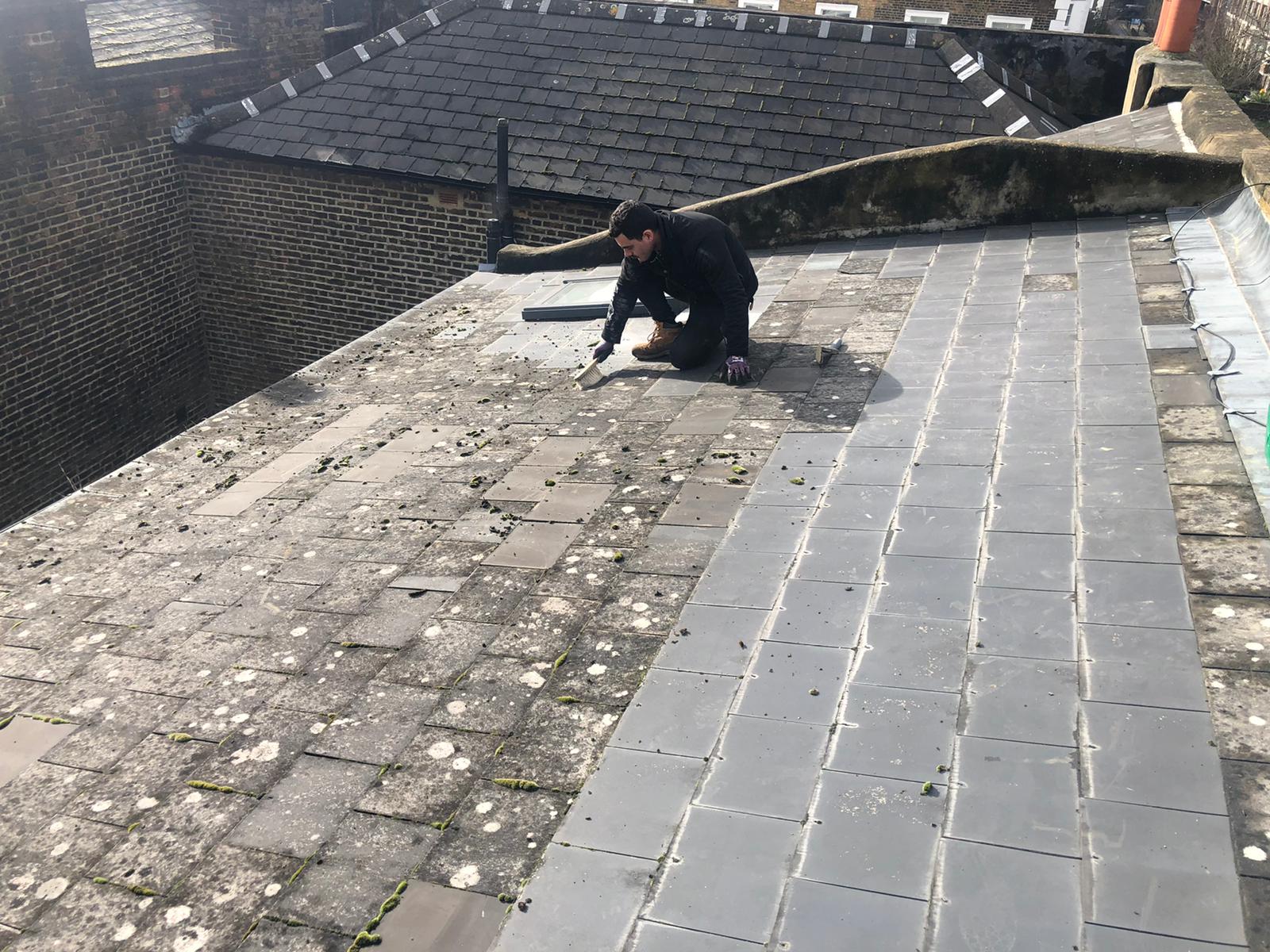

Roof Photo 7
Additional view of roof alterations
-
View

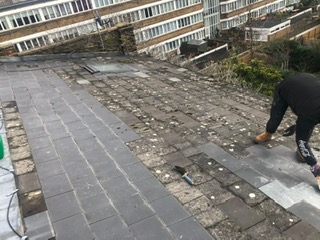

Roof Photo 8
Additional roof photograph
Evidence Documentation
-
View
Evidence README - Full Documentation
Complete documentation of all evidence in this folder with legal relevance analysis
Original Roof Repairs Folder
-
View
Roof Guarantee Certificate (Original Location)
Solution Roofing 10-year guarantee certificate
Insurance Documents
Building insurance policies for 14-16 Carroun Road
2025 Policy
-
View
Certificate of Insurance 2025
Insurance certificate for current policy period
-
View
Policy Schedule 2025
Schedule detailing coverage and terms
-
View
Policy Summary 2025
Summary of policy coverage
-
View
Policy Wording 2025
Full policy terms and conditions
2026 Policy
Draft Response Letters to Wright Hassall
Draft letters prepared for response to Wright Hassall LLP
Benchmark Solicitors Onboarding
Client care documents from Benchmark Solicitors LLP
Original Email Files (.eml) & Comprehensive Timelines
Raw email files and comprehensive timeline analysis
- Katerina-Al Timeline: 71 emails (November 2016 - July 2025)
- Katerina-Stan Timeline: 50+ emails (March 2022 - January 2025)
- Al-Stan Timeline: Direct correspondence between Al Sarpong and Stan Harris
- Katerina-Ross Timeline: Complete correspondence (October 2025 - January 2026)
- Wright Hassall Timeline: 3 formal letters (October 2025 - January 2026)
Raw .eml files location: C:\Users\Kater\Desktop\CARROUN\EMAILS\
Note: Original .eml files can be viewed in any email client (Outlook, Thunderbird) or text editor. Chain emails contain multiple messages that have been extracted into the timelines above.
